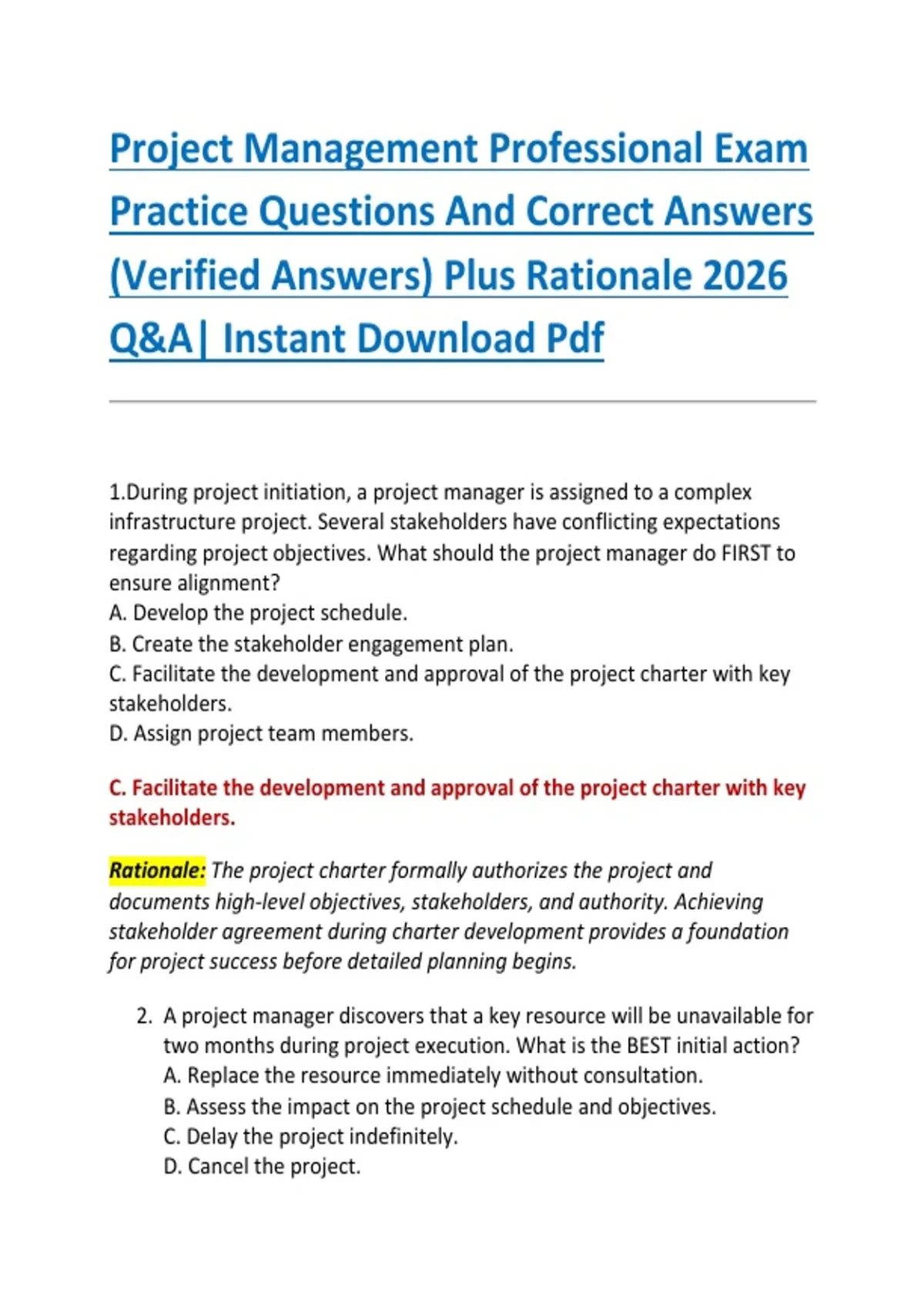

1.During project initiation, a project manager is assigned to a complex
infrastructure project. Several stakeholders have conflicting expectations
regarding project objectives. What should the project manager do FIRST to
ensure alignment?
A. Develop the project schedule.
B. Create the stakeholder engagement plan.
C. Facilitate the development and approval of the project charter with key
stakeholders.
D. Assign project team members.
C. Facilitate the development and approval of the project charter with key
stakeholders.
Rationale: The project charter formally authorizes the project and
documents high-level objectives, stakeholders, and authority. Achieving
stakeholder agreement during charter development provides a foundation
for project success before detailed planning begins.
2. A project manager discovers that a key resource will be unavailable for
two months during project execution. What is the BEST initial action?
A. Replace the resource immediately without consultation.
B. Assess the impact on the project schedule and objectives.
C. Delay the project indefinitely.
D. Cancel the project.
,B. Assess the impact on the project schedule and objectives.
Rationale: Evaluating the impact allows the project manager to understand
schedule, cost, quality, and scope implications before determining the most
appropriate response.
3. Which document formally authorizes the existence of a project?
A. Risk Register
B. Project Charter
C. Scope Baseline
D. Communications Management Plan
B. Project Charter
Rationale: The project charter authorizes the project, identifies the project
manager, and grants authority to apply organizational resources to project
activities.
4. During planning, stakeholders request additional features that were
not included in the original requirements. What should the project
manager do?
A. Accept the changes immediately.
B. Reject all changes.
C. Submit the requested changes through integrated change control.
D. Ignore the requests.
C. Submit the requested changes through integrated change control.
Rationale: Formal change control ensures that requested changes are
evaluated for impacts on scope, schedule, cost, quality, and risk before
approval or rejection.
5. Which process group includes developing the project management
plan?
A. Initiating
B. Planning
, C. Executing
D. Closing
B. Planning
Rationale: The project management plan is developed during the Planning
Process Group and integrates all subsidiary management plans.
6. A project manager notices that actual project costs are significantly
exceeding planned costs. Which earned value metric indicates this
condition?
A. SPI greater than 1
B. CPI less than 1
C. CV greater than 0
D. SV greater than 0
B. CPI less than 1
Rationale: A Cost Performance Index (CPI) below 1 indicates that the project
is spending more than planned for the work accomplished.
7. Which leadership style is MOST appropriate when managing a highly
skilled and self-motivated project team?
A. Autocratic
B. Laissez-faire
C. Directive
D. Coercive
B. Laissez-faire
Rationale: Highly competent and motivated teams often perform best with a
leadership style that empowers autonomy while maintaining accountability.
8. What is the PRIMARY purpose of a stakeholder register?
A. Define project budget.
B. Identify and analyze stakeholders.
, C. Develop the project schedule.
D. Estimate project costs.
B. Identify and analyze stakeholders.
Rationale: The stakeholder register documents stakeholder information,
interests, influence, and engagement to support effective communication
and management.
9. Which document defines how project scope will be validated and
controlled?
A. Scope Management Plan
B. Procurement Plan
C. Cost Baseline
D. Issue Log
A. Scope Management Plan
Rationale: The Scope Management Plan establishes procedures for defining,
validating, and controlling project scope.
10. A project activity has zero total float. What does this indicate?
A. It is optional.
B. It is not on the critical path.
C. Any delay will delay project completion.
D. It has unlimited scheduling flexibility.
C. Any delay will delay project completion.
Rationale: Activities with zero float are on the critical path, meaning delays
directly impact the project's finish date.
11. Which estimating technique uses historical information from
similar projects?
A. Bottom-up estimating
B. Analogous estimating
Practice Questions And Correct Answers
(Verified Answers) Plus Rationale 2026
Q&A| Instant Download Pdf
1.During project initiation, a project manager is assigned to a complex
infrastructure project. Several stakeholders have conflicting expectations
regarding project objectives. What should the project manager do FIRST to
ensure alignment?
A. Develop the project schedule.
B. Create the stakeholder engagement plan.
C. Facilitate the development and approval of the project charter with key
stakeholders.
D. Assign project team members.
C. Facilitate the development and approval of the project charter with key
stakeholders.
Rationale: The project charter formally authorizes the project and
documents high-level objectives, stakeholders, and authority. Achieving
stakeholder agreement during charter development provides a foundation
for project success before detailed planning begins.
2. A project manager discovers that a key resource will be unavailable for
two months during project execution. What is the BEST initial action?
A. Replace the resource immediately without consultation.
B. Assess the impact on the project schedule and objectives.
C. Delay the project indefinitely.
D. Cancel the project.
,B. Assess the impact on the project schedule and objectives.
Rationale: Evaluating the impact allows the project manager to understand
schedule, cost, quality, and scope implications before determining the most
appropriate response.
3. Which document formally authorizes the existence of a project?
A. Risk Register
B. Project Charter
C. Scope Baseline
D. Communications Management Plan
B. Project Charter
Rationale: The project charter authorizes the project, identifies the project
manager, and grants authority to apply organizational resources to project
activities.
4. During planning, stakeholders request additional features that were
not included in the original requirements. What should the project
manager do?
A. Accept the changes immediately.
B. Reject all changes.
C. Submit the requested changes through integrated change control.
D. Ignore the requests.
C. Submit the requested changes through integrated change control.
Rationale: Formal change control ensures that requested changes are
evaluated for impacts on scope, schedule, cost, quality, and risk before
approval or rejection.
5. Which process group includes developing the project management
plan?
A. Initiating
B. Planning
, C. Executing
D. Closing
B. Planning
Rationale: The project management plan is developed during the Planning
Process Group and integrates all subsidiary management plans.
6. A project manager notices that actual project costs are significantly
exceeding planned costs. Which earned value metric indicates this
condition?
A. SPI greater than 1
B. CPI less than 1
C. CV greater than 0
D. SV greater than 0
B. CPI less than 1
Rationale: A Cost Performance Index (CPI) below 1 indicates that the project
is spending more than planned for the work accomplished.
7. Which leadership style is MOST appropriate when managing a highly
skilled and self-motivated project team?
A. Autocratic
B. Laissez-faire
C. Directive
D. Coercive
B. Laissez-faire
Rationale: Highly competent and motivated teams often perform best with a
leadership style that empowers autonomy while maintaining accountability.
8. What is the PRIMARY purpose of a stakeholder register?
A. Define project budget.
B. Identify and analyze stakeholders.
, C. Develop the project schedule.
D. Estimate project costs.
B. Identify and analyze stakeholders.
Rationale: The stakeholder register documents stakeholder information,
interests, influence, and engagement to support effective communication
and management.
9. Which document defines how project scope will be validated and
controlled?
A. Scope Management Plan
B. Procurement Plan
C. Cost Baseline
D. Issue Log
A. Scope Management Plan
Rationale: The Scope Management Plan establishes procedures for defining,
validating, and controlling project scope.
10. A project activity has zero total float. What does this indicate?
A. It is optional.
B. It is not on the critical path.
C. Any delay will delay project completion.
D. It has unlimited scheduling flexibility.
C. Any delay will delay project completion.
Rationale: Activities with zero float are on the critical path, meaning delays
directly impact the project's finish date.
11. Which estimating technique uses historical information from
similar projects?
A. Bottom-up estimating
B. Analogous estimating
