DBIA Certification Exam 2026/2027 | Design-Build Questions & Study Guide

Document preview thumbnail
Voorbeeld 3 van de 26 pagina's

Prepare for the DBIA Certification Exam with this latest-release 2026/2027 study resource designed for focused review of Design-Build Done Right® principles and certification topics. The material supports preparation across guiding principles, design-build foundations, procurement, contracting, project execution, collaboration, risk management, and design-build best practices. DBIA states that its certification exam consists of 100 questions and assesses mastery and application of design-build best practices.

Voorbeeld van de inhoud

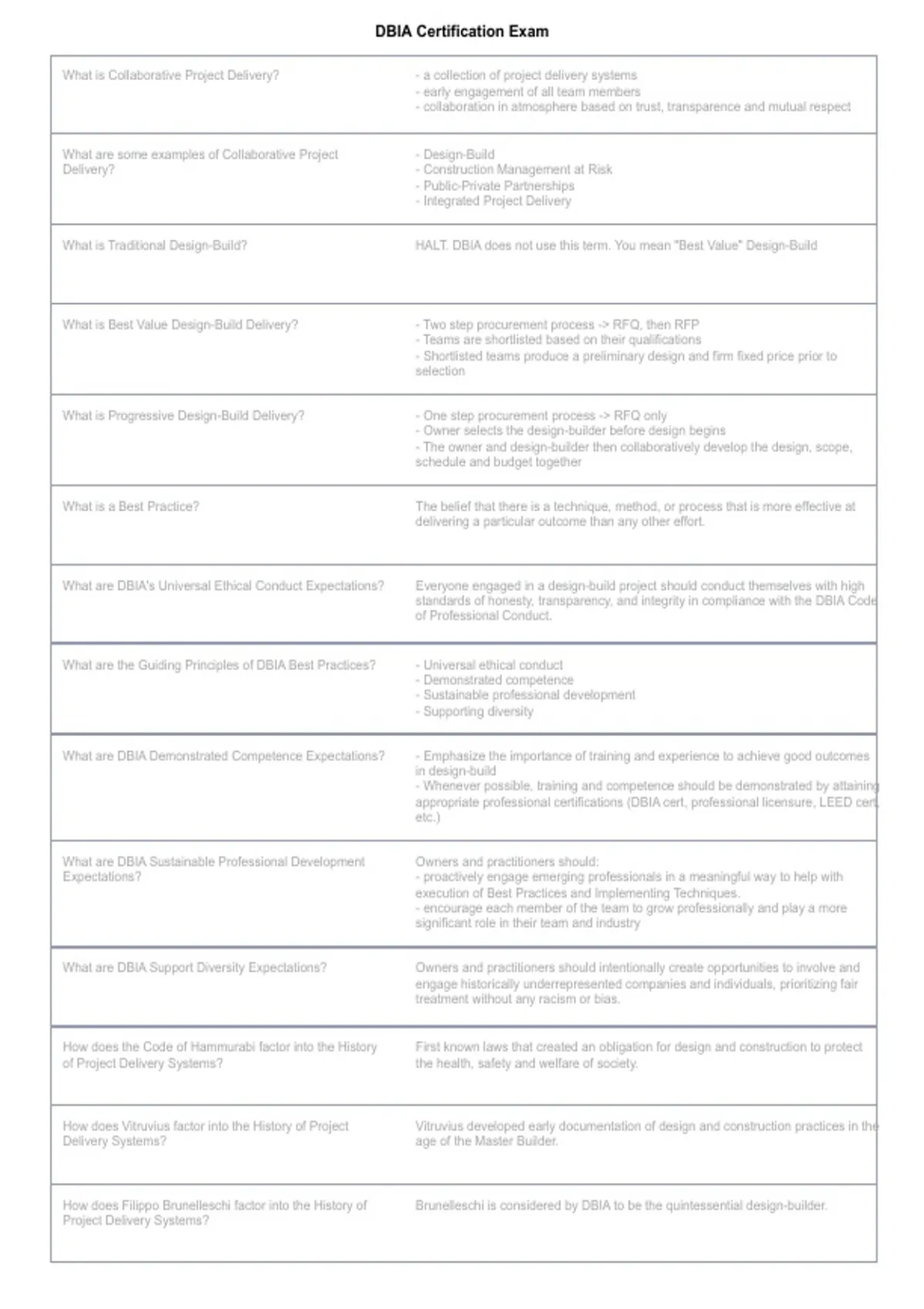

DBIA Certification Exam

What is Collaborative Project Delivery? - a collection of project delivery systems
- early engagement of all team members
- collaboration in atmosphere based on trust, transparence and mutual respect


What are some examples of Collaborative Project - Design-Build
Delivery? - Construction Management at Risk
- Public-Private Partnerships
- Integrated Project Delivery


What is Traditional Design-Build? HALT. DBIA does not use this term. You mean "Best Value" Design-Build




What is Best Value Design-Build Delivery? - Two step procurement process -> RFQ, then RFP
- Teams are shortlisted based on their qualifications
- Shortlisted teams produce a preliminary design and firm fixed price prior to
selection


What is Progressive Design-Build Delivery? - One step procurement process -> RFQ only
- Owner selects the design-builder before design begins
- The owner and design-builder then collaboratively develop the design, scope,
schedule and budget together


What is a Best Practice? The belief that there is a technique, method, or process that is more effective at
delivering a particular outcome than any other effort.



What are DBIA's Universal Ethical Conduct Expectations? Everyone engaged in a design-build project should conduct themselves with high
standards of honesty, transparency, and integrity in compliance with the DBIA Code
of Professional Conduct.


What are the Guiding Principles of DBIA Best Practices? - Universal ethical conduct
- Demonstrated competence
- Sustainable professional development
- Supporting diversity


What are DBIA Demonstrated Competence Expectations? - Emphasize the importance of training and experience to achieve good outcomes
in design-build
- Whenever possible, training and competence should be demonstrated by attaining
appropriate professional certifications (DBIA cert, professional licensure, LEED cert,
etc.)


What are DBIA Sustainable Professional Development Owners and practitioners should:
Expectations? - proactively engage emerging professionals in a meaningful way to help with
execution of Best Practices and Implementing Techniques.
- encourage each member of the team to grow professionally and play a more
significant role in their team and industry


What are DBIA Support Diversity Expectations? Owners and practitioners should intentionally create opportunities to involve and
engage historically underrepresented companies and individuals, prioritizing fair
treatment without any racism or bias.


How does the Code of Hammurabi factor into the History First known laws that created an obligation for design and construction to protect
of Project Delivery Systems? the health, safety and welfare of society.



How does Vitruvius factor into the History of Project Vitruvius developed early documentation of design and construction practices in the
Delivery Systems? age of the Master Builder.



How does Filippo Brunelleschi factor into the History of Brunelleschi is considered by DBIA to be the quintessential design-builder.
Project Delivery Systems?

, DBIA Certification Exam

How does Leon Battista Alberti factor into the History of Alberti defined architecture as a profession distinct from construction.
Project Delivery Systems?



When did we see the big split between design and During the Industrial Revolution.
construction? Why? This is when we started to fabricate construction materials en masse, rather than on
site. This led to further stratification/compartmentalization of A/E/C discplines.


When do we see the rise of professional societies like During the Industrial Revolution.
ASCE, AIA and AGC? Why were they established? They were established to reflect and collect the specialized knowledge needed in
each dedicated disciplines -- engineers, architects and construction professionals.


What is the Spearin Act? -




What is the Miller Act? Requires bonding for Federal Projects costing more than $100,000




What is the Brooks Act? Requires hiring Design Professionals on the basis of qualifications rather than cost
of service



What is the Clinger-Cohen Act? Authorized use of design-build of federal sector projects




What does the cost/influence curve demonstrate? The earlier on in the design development process design changes get made, the
greater their influence and lower their cost.



How is a design-build project delivery system defined? A single contract for both design and construction. Between an owner and a design-
build entity.



Is the design-build project delivery system a process only? No, it's also a mindset/culture shift. There has to be an atmosphere of transparency
and trust between all parties. Team members must choose to collaborate.



Is there any process flexibility in the design-build project Yes. The owner can choose to pursue either a best value design-build or
delivery model? progressive design-build approach.



What are the benefits of the design-build delivery system? - An owner may select a builder on a basis other than low bid
- Flexible organizational structure (designer-led, contractor-led, developer-led, etc.)
- Builders and trade partners have a "voice" in optimizing the design DURING
design development (lowers cost impact of changes/improvements)
- Collaborative nature of process promotes innovation and creativity
- The owner is substantially removed from the Standard of Care/Spearin Doctrine
claims -- the design-builder is responsible for the design, not them


What are some features of the design-bid-build project - the owner has two contracts, one with the designer and another with the contractor
delivery system. - there is a separation of design from construction
- sequential: design then bid then build (cannot be compressed or fast-tracked)
- popular. Very familiar and established processes & procedures.
- Owner carries the responsibility for accuracy of design (Spearin Doctrine applies)


On what basis are design professionals selected in design- Selected on the basis of qualifications.
bid-build project delivery?

, DBIA Certification Exam

On what basis are contractors typically selected in design- Selected on the basis of low bid.
bid-build project delivery?



How is the construction manager at risk project delivery - design and construction are separated under two contracts held by the owner
system similar to design-bid-build? - mostly linear
- Owner carries risk for design


How is the construction manager at risk project delivery - some opportunity to fast track, as construction manager can be hired to perform
system similar to design-build? some preconstruction services like constructability assessments
- CM selected on qualifications
- Helps owner establish contract price and GMP before design is complete


How does the multi-prime project delivery system function? - the owner manages a ton of different contracts -- with design professional as well
as a variety of trade contractors
- an owner advisor may be hired to advise the owner on how to administer their
multiple contracts


How does the integrated project delivery system function? - This is a multi-party contract, featuring a variety of entities like owner, architect,
specialty consultants, general contractor, trade partners, etc.
- All parties agree to the terms and conditions of a single contract

- can be treated as a philosophy rather than a contract type
- exclusively a private sector delivery method


What are the benefits of contracting under a single - risk allocation. One contract allows for equitable assignment of risk to the party
contract? best able to manage it.



When should an owner conduct a risk and opportunity - during project planning before procurement to set up a contract with the correct
analysis for a project? incentive structure
- during validation and contract negotiations, with design-builder involvement


What is the first thing an Owner should do during strategic The owner should conduct a proactive and objective assessment of the unique
project delivery planning? (Best Practice #1) characteristics of its program/project and its organization before deciding to use
design-build.


What is a project delivery system? Identifies contractual relationships between parties in a construction project. Defines
when and how each party will fulfill its responsibilities.
aka How Teams are Organized


What is a procurement method? Establishes how the Owner will select the providers of design and construction
services needed to complete the project.
aka How Teams are Selected


What are some examples of common procurement - Best Value
methods? - Qualifications Based Selection/Progressive Design Build
- Low Bid
- Negotiated
- Sole Source (Directly Selected)


What is the contract format? Designates the basis on which the parties will be paid for performing the work of the
project.
aka How Teams are Paid


What are examples of common contract formats? - Lump Sum (Fixed Price)
- Guaranteed Maximum Price (GMP)
- Cost Plus Fee
- Target Price
- Unit Price

Documentinformatie

Geüpload op
8 september 2026
Aantal pagina's
26
Geschreven in
2026/2027
Type
Tentamen (uitwerkingen)
Bevat
Vragen en antwoorden
$9.99

Verkeerd document? Gratis ruilen Binnen 14 dagen na aankoop en voor het downloaden kan je een ander document kiezen. Je kan het bedrag gewoon opnieuw besteden.
Geschreven door studenten die geslaagd zijn
Direct beschikbaar na je betaling
Online lezen of als PDF

Seller avatar
De reputatie van een verkoper is gebaseerd op het aantal documenten dat iemand tegen betaling verkocht heeft en de beoordelingen die voor die items ontvangen zijn. Er zijn drie niveau’s te onderscheiden: brons, zilver en goud. Hoe beter de reputatie, hoe meer de kwaliteit van zijn of haar werk te vertrouwen is.
TestproCenter
4.4
(21)
Verkocht
80
Volgers
0
Items
3427
Laatst verkocht
22 uur geleden



Waarom studenten kiezen voor Stuvia

Gemaakt door medestudenten, geverifieerd door reviews

Kwaliteit die je kunt vertrouwen: geschreven door studenten die slaagden en beoordeeld door anderen die dit document gebruikten.

Niet tevreden? Kies een ander document

Geen zorgen! Je kunt voor hetzelfde geld direct een ander document kiezen dat beter past bij wat je zoekt.

Betaal zoals je wilt, start meteen met leren

Geen abonnement, geen verplichtingen. Betaal zoals je gewend bent via Bancontact, iDeal of creditcard en download je PDF-document meteen.

Student with book image

“Gekocht, gedownload en geslaagd. Zo eenvoudig kan het zijn.”

Alisha Student

Bezig met je bronvermelding?

Maak nauwkeurige citaten in APA, MLA en Harvard met onze gratis bronnengenerator.

Bezig met je bronvermelding?

Veelgestelde vragen
