Summary Zelfstudiepakket projectmanagement

Document preview thumbnail
Voorbeeld 4 van de 52 pagina's

Dit is een samenvatting van het zelfstudiepakket projectmanagement voor het vak geïntegreerde casus en projectmanagement in de Master Milieuwetenschappen. Dit vak wordt ook gegeven aan de opleiding Master Stedenbouw en Ruimtelijke planning, maar les 10 ontbreekt in deze samenvatting.

Voorbeeld van de inhoud

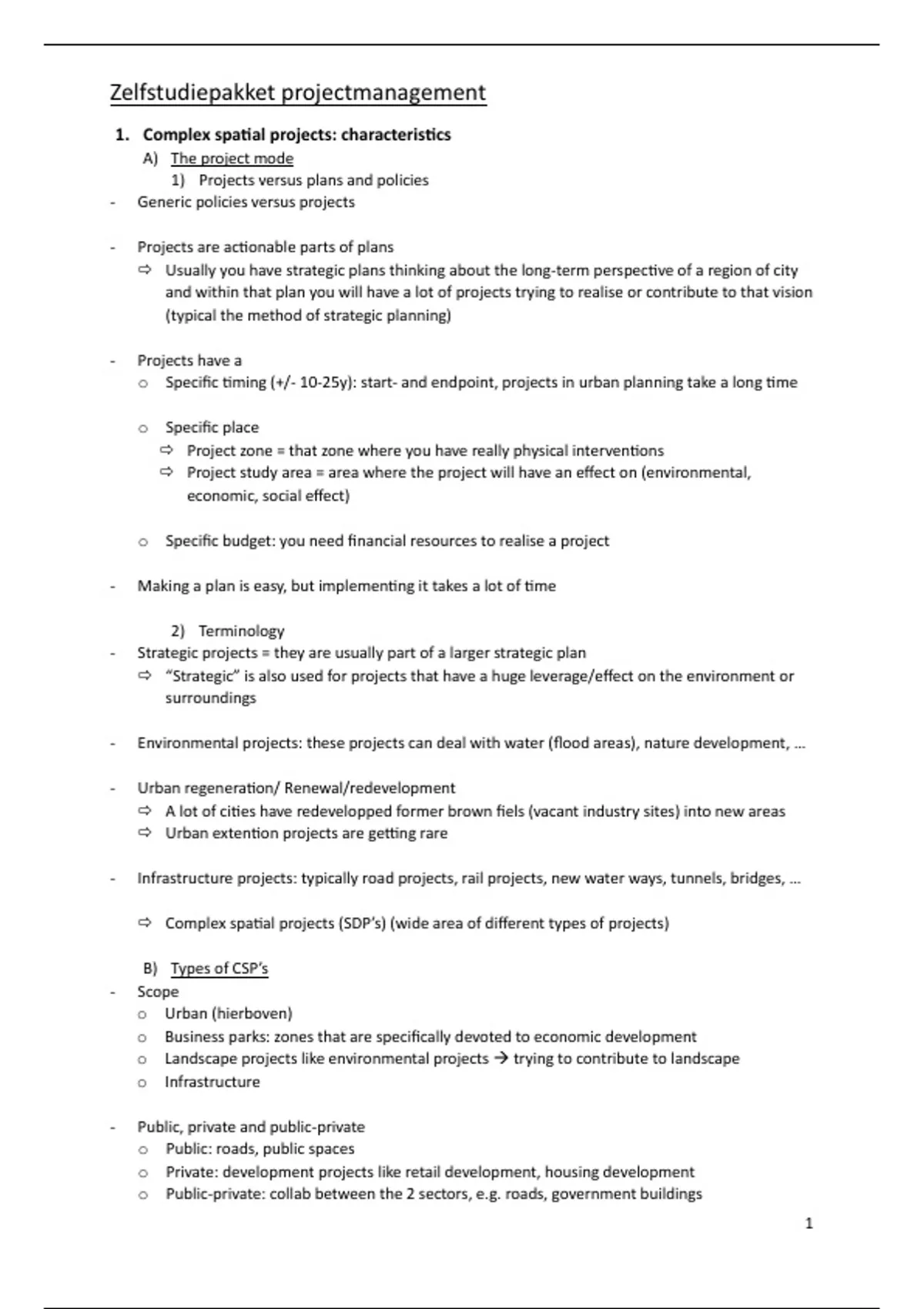

Zelfstudiepakket projectmanagement
1. Complex spatial projects: characteristics
A) The project mode
1) Projects versus plans and policies
- Generic policies versus projects

- Projects are actionable parts of plans
 Usually you have strategic plans thinking about the long-term perspective of a region of city
and within that plan you will have a lot of projects trying to realise or contribute to that vision
(typical the method of strategic planning)

- Projects have a
o Specific timing (+/- 10-25y): start- and endpoint, projects in urban planning take a long time

o Specific place
 Project zone = that zone where you have really physical interventions
 Project study area = area where the project will have an effect on (environmental,
economic, social effect)

o Specific budget: you need financial resources to realise a project

- Making a plan is easy, but implementing it takes a lot of time

2) Terminology
- Strategic projects = they are usually part of a larger strategic plan
 “Strategic” is also used for projects that have a huge leverage/effect on the environment or
surroundings

- Environmental projects: these projects can deal with water (flood areas), nature development, …

- Urban regeneration/ Renewal/redevelopment
 A lot of cities have redevelopped former brown fiels (vacant industry sites) into new areas
 Urban extention projects are getting rare

- Infrastructure projects: typically road projects, rail projects, new water ways, tunnels, bridges, …

 Complex spatial projects (SDP’s) (wide area of different types of projects)

B) Types of CSP’s
- Scope
o Urban (hierboven)
o Business parks: zones that are specifically devoted to economic development
o Landscape projects like environmental projects → trying to contribute to landscape
o Infrastructure

- Public, private and public-private
o Public: roads, public spaces
o Private: development projects like retail development, housing development
o Public-private: collab between the 2 sectors, e.g. roads, government buildings
1

,- Single goal versus multiple goals
o Single: the project is trying to achieve 1 main goal, e.g. infrastructure projects
o Multiple: we try to combine more goals in 1 project, more robust plan because more people
benefit from it

- Greenfield versus brownfield
o Greenfield: projects that are developed on unbuilt land, e.g. housing extension areas and
new business parks

o Brownfield: generally much more complex and demanding
 Often has to deal with problems of soil contamination, costly conservation & restauration,
fragmentation of ownership, and low market demand and high development costs

- Strategic versus operational
o Strategic: projects you do once
o Operational: projects on a routine basis, reoccurring project e.g. renewing the streets every
now and then

- Examples (zie ppt voor andere):
Schelde - Public: funded by the city of Antwerp and the administration
that takes care of water ways in Flanders

- Schelde
 Used to be an economic area (docks)
 Whole new public space: reason has to do with the
potential flooding of the Schelde

PAKT - Private

- PAKT next to Groen Kwartier (which was public –private)
 Former warehouse that was transformed into a nice area
with restaurants and rooftop gardens



Nieuw-Zuid - Private developer financed it, but the masterplan was made
in close cooperation with the public authority

- Nieuw-Zuid
 Former industrial land (activities from the port)
 A masterplan was drawn up in 1993, now it’s implemented

Crossing of the Schelde - Started single goal, infrastructure project
 Gradually into multiple goal
 Chanses of succeeding with a single goal projects are very
small




2

, C) Management characteristics of CSP’s
1) What is meant by “complexity”?
- Complexity = different from complicated, which means difficult

- Complexity → complex systems theory: defines complex system as
o Systems with many components
o Systems with high distinction between components
o Mutual dependent between the different components to work
 If one of the parts of the components fails, usually the whole system can fail

- Complex systems and complex adaptive systems usually have a non-linear behaviour
 A small deviation in one of the components might have a large effect
 Ex. airplane: al the components of the airplane has to work together in order for it to fly

2) Types of complexity
a) Technological complexity (design & engineering)
- Unicity and novelty of technology: unique projects, when a project is unique you can’t really learn
out of former projects (= “problem”)
 Learning is very difficult
 The effects of different projects on their surroundings are difficult to assess
 Harder to realise the project

- Functional interdependencies: the more you have, the more complex the project becomes

- Uncertainty regarding the impact: we have models to predict, but the models are often
incomplete, they have to take into account certain parameters that are estimations and nobody
can look into the future, we’re always guessing (educated guess)
 One of the weak points of bigger projects

- Technological dynamics during the project: see in a broader scope, can also refer to regulations
regarding (that can change during the project)

- Technical characteristics of projects affecting manageability




o Robustness and overdesign: for each system there is a backup system, different design
solutions in case one of the system fails, overdesign is also thinking of multiple uses that
could happen in the future
 Ex. building a bridge, make it extra wide of when an extra lane is needed later in time

o Proven technology: use only technology that has been proven or has been used before to
learn from previous experiences (will less likely fail)

3

, o Divisible: independency between different parts, realization can be in phases
 Loose coupling: parts shouldn't be connected to each other, are only loosely related

o Monofunctional: links between the functions can be problematic
o Incremental implementation: during phases lessons are learned and following phases can be
changed

- Ex. Kessel-Lo, Leuven railway station: tunnel under square for cars
o A lot of functions combined in the same buildings
o If everything is built at the same time not al functions will get
filled because of the market at the time

o It is better to have separate buildings for the functions and
reversible buildings to phase the development

b) Organizational complexity
- Public organisations, private organisations, civil society
 A lot of people are involved you need private developers to contribute, private developers are
dependent on the local authority for permits etc.

- Mutual dependency (resource dependency): different actors with different resources that need te
be combined for the plan to work
 None of the organisations is able to go for unilateral strategy, do it without the other parties

- Obliged to cooperate

- Example: Park Spoor Noord, old railway station, made to a park
 Compromise: the land can be made to a park, but at the head can be high rise buildings with
residencies

c) Societal complexity
- Large societal impact: they have an effect on the environment, the economy, on social issues
 Impact can be large

- Differential impact on society: each of this projects creates winner and losers
 Those that lose (don’t benefit): can unite and challenge the project

- Projects result in societal struggles: action groups opposing the projects
 If you don’t have action groups, there’s something wrong with the project

d) Political complexity
- Different political preferences: not all parties will agree with the project
- Political rivalry : political actors block each other
- Multi-level governance

- Effect of elections on projects (over-promising, upspeeding): before elections is the best moment
to announce a project




4

Documentinformatie

Geüpload op
15 oktober 2026
Aantal pagina's
52
Geschreven in
2026/2027
Type
Samenvatting
€10,16

Verkeerd document? Gratis ruilen Binnen 14 dagen na aankoop en voor het downloaden kan je een ander document kiezen. Je kan het bedrag gewoon opnieuw besteden.
Geschreven door studenten die geslaagd zijn
Direct beschikbaar na je betaling
Online lezen of als PDF

Seller avatar
De reputatie van een verkoper is gebaseerd op het aantal documenten dat iemand tegen betaling verkocht heeft en de beoordelingen die voor die items ontvangen zijn. Er zijn drie niveau’s te onderscheiden: brons, zilver en goud. Hoe beter de reputatie, hoe meer de kwaliteit van zijn of haar werk te vertrouwen is.
APUAstudent
4,5
(2)
Verkocht
62
Volgers
0
Items
72
Laatst verkocht
1 week geleden



Waarom studenten kiezen voor Stuvia

Gemaakt door medestudenten, geverifieerd door reviews

Kwaliteit die je kunt vertrouwen: geschreven door studenten die slaagden en beoordeeld door anderen die dit document gebruikten.

Niet tevreden? Kies een ander document

Geen zorgen! Je kunt voor hetzelfde geld direct een ander document kiezen dat beter past bij wat je zoekt.

Betaal zoals je wilt, start meteen met leren

Geen abonnement, geen verplichtingen. Betaal zoals je gewend bent via Bancontact, iDeal of creditcard en download je PDF-document meteen.

Student with book image

“Gekocht, gedownload en geslaagd. Zo eenvoudig kan het zijn.”

Alisha Student

Bezig met je bronvermelding?

Maak nauwkeurige citaten in APA, MLA en Harvard met onze gratis bronnengenerator.

Bezig met je bronvermelding?

Veelgestelde vragen
